Hyperbuilding 02 Data Team: From KPI Calculation to Native BIM Documentation

Introduction

Hyperbuilding 02 Data Team developed an interoperability workflow that transforms analytical performance data into native BIM documentation. Instead of keeping KPI evaluation outside the architectural model, the project uses Rhino.Inside.Revit to transfer computed values into Revit, where they can be read through schedules, color-coded views, annotated drawings, and sheet-based documentation.

Cover image showing the Hyperbuilding 02 interoperability workflow from KPI analysis to BIM documentation.
Opening visual of the Hyperbuilding 02 data workflow, where performance logic is translated into documentable building information.

This approach addresses a recurring problem in computational design workflows: geometry, analysis, and documentation are often produced in separate environments. As a result, performance data becomes harder to communicate, review, and compare during design development. The goal of this work was to close that gap by embedding performance logic directly into the Revit model environment.

Within the Integrative Modeling seminar, interoperability is not only a technical issue. It is a design problem, a data problem, and a documentation problem. The contribution of the Data Team was to define a shared framework where geometry, metadata, validation, and visualization could work together. In this workflow, analytical values are no longer isolated in spreadsheets or external simulation interfaces. They become part of the architectural model itself.

Interoperability as a Design Problem

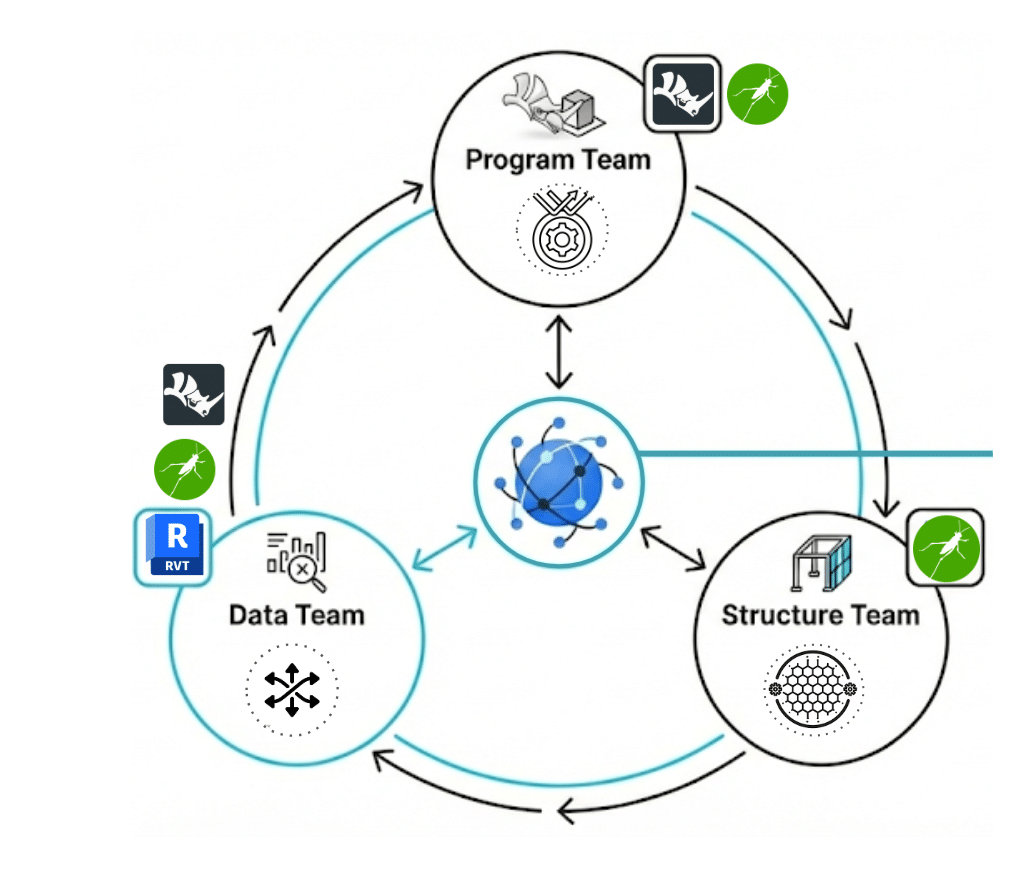

Diagram showing the Data Team as the integration layer between disciplines and shared model outputs.
The Data Team operates as an integration layer between disciplines, aligning shared inputs, validation logic, and model-based outputs.

Interoperability Workflow

The workflow begins with shared geometric and analytical inputs coming from Rhino, Grasshopper, and team-based model exchange. Areas, volumes, levels, and element identifiers are extracted and structured in Grasshopper. KPI values are then calculated and organized per level or per element. Through Rhino.Inside.Revit, this data is pushed into Revit as instance-based information, making it available for filters, schedules, legends, and sheets.

This workflow does not treat Revit as a passive receiver of geometry. Revit becomes the final information environment where performance is visualized, checked, and documented. The result is a model that supports both design interpretation and final communication.

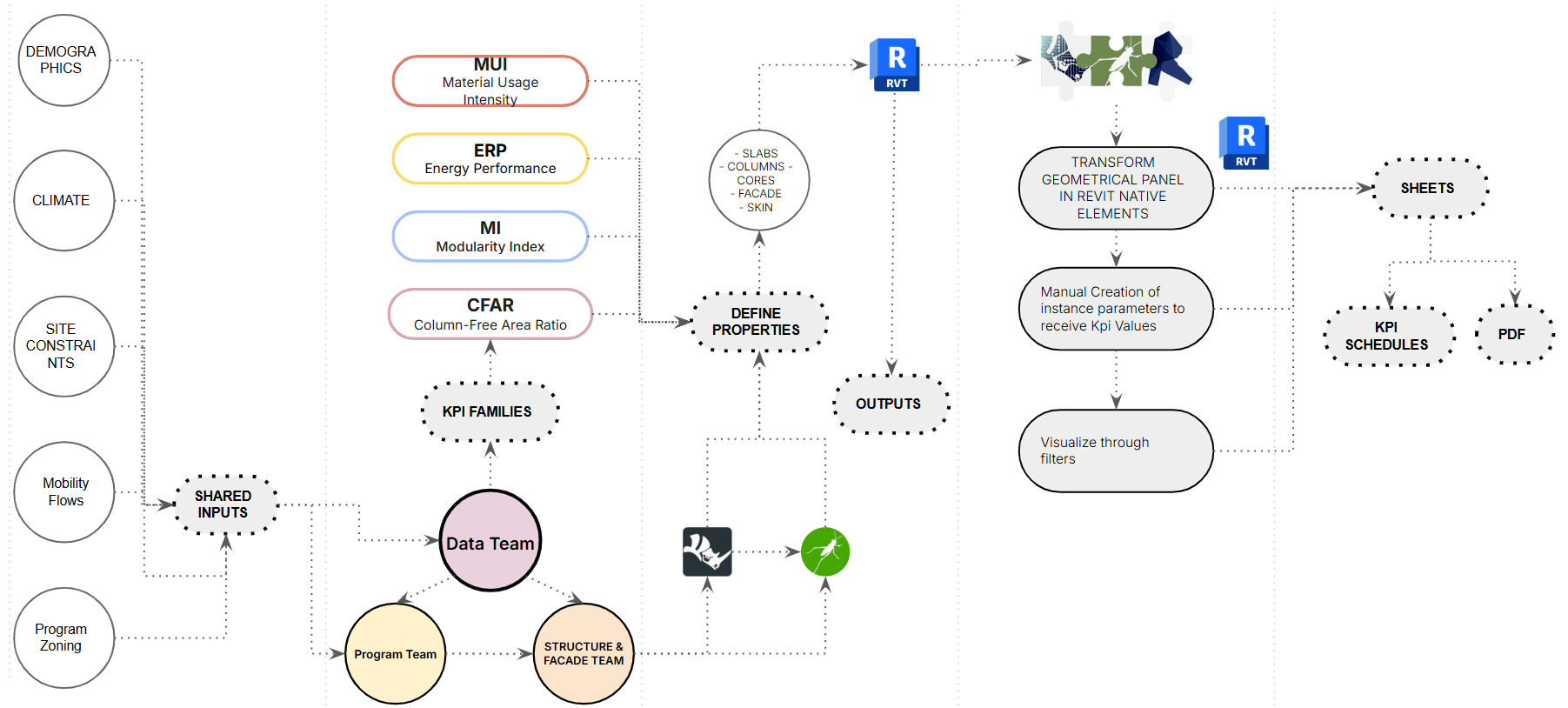

Interoperability workflow from Grasshopper data processing to native Revit documentation outputs.
From shared inputs to Revit sheets, the workflow structures KPI families, assigns properties, and translates analysis into native documentation outputs.

KPI Framework

The KPI system was restructured into five clearly defined groups based on measurable outputs:

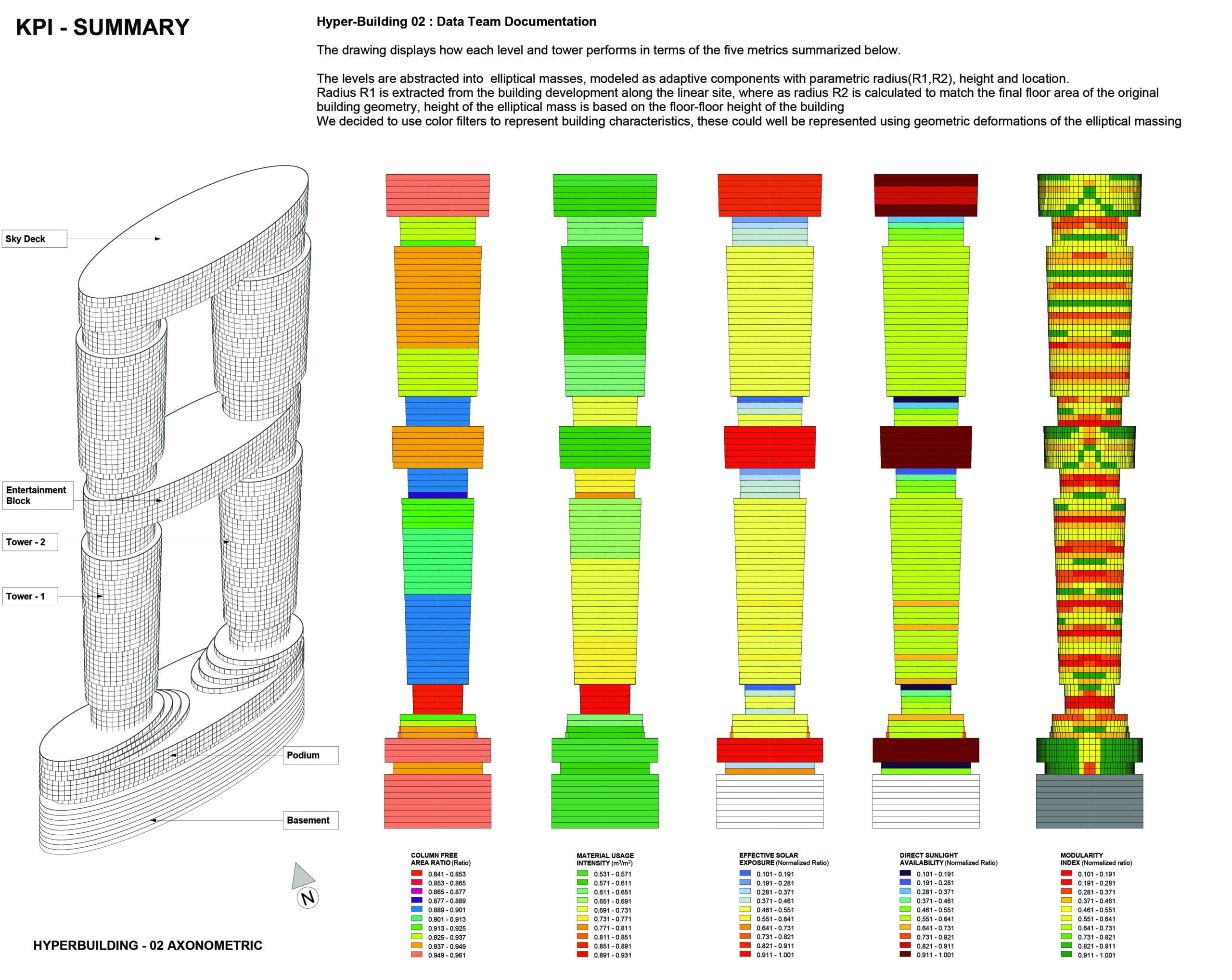

Summary sheet showing level-based KPI performance through abstract elliptical masses.

Spatial KPI

  • CFAR (Column-Free Area Ratio): evaluates the proportion of circulation area relative to usable floor area.

Material KPI

  • MUI (Material Usage Index): measures material distribution efficiency across different levels.

Solar Exposure KPIs

  • Effective Solar Exposure: measures the building’s exposure to solar gains and its impact on energy performance and thermal comfort.
  • Direct Sunlight Availability: measures access to natural light and its influence on daylight quality and occupant comfort.

Façade Rationalization KPI

  • Modularity-I: evaluates the degree of façade standardization based on panel typologies.

Façade Solar Analysis

  • ISR (Incident Solar Radiation): measures the total annual solar radiation received by façade surfaces.
  • DSH (Direct Sun Hours): measures the number of hours façade surfaces receive direct sunlight.

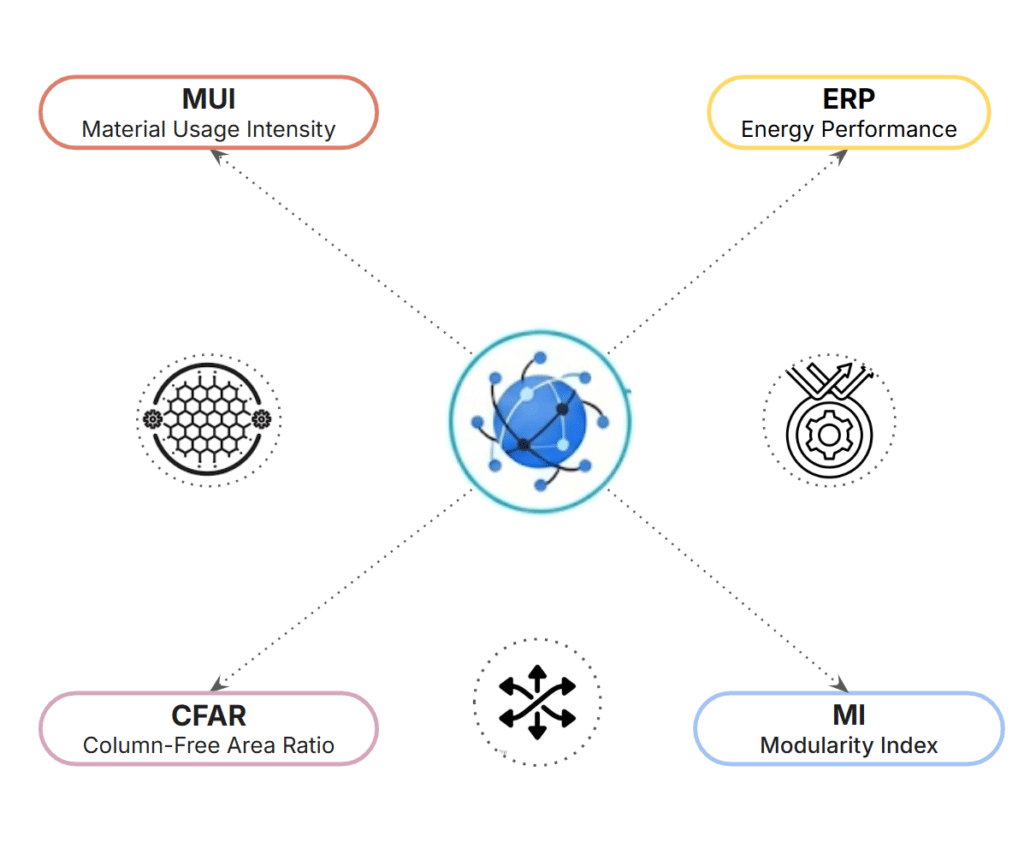

Diagram of the KPI families used in the BIM evaluation framework.
The KPI framework consolidates spatial, material, modular, and environmental readings into a shared evaluation structure for the BIM model.

KPI Sheets

First, a summary of the building’s performance is presented. Then, each KPI is displayed on a specific sheet with views and a schedule.

1. Column-Free Area Ratio (CFAR)

CFAR documentation sheet with axonometric, elevations, and level schedule.

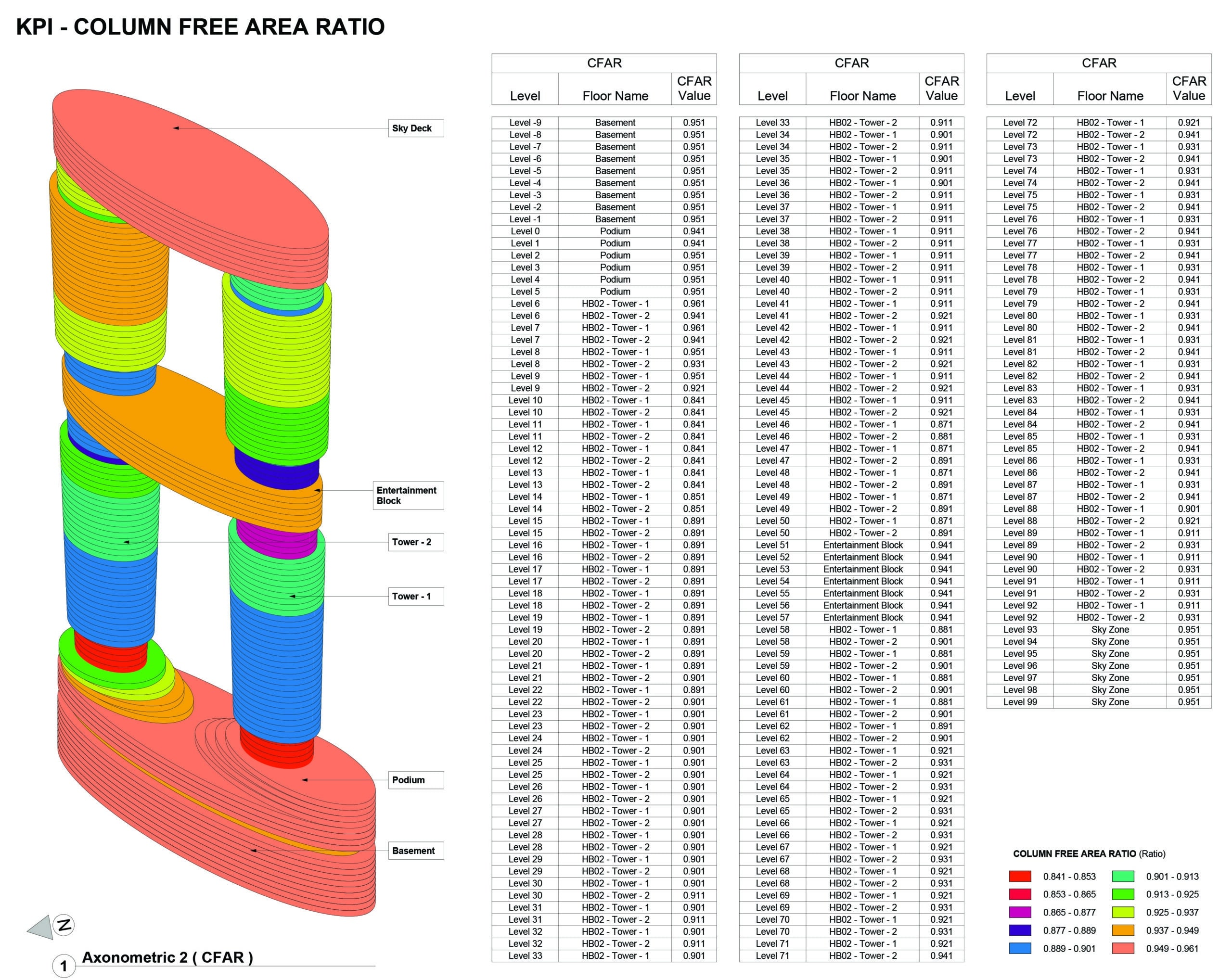

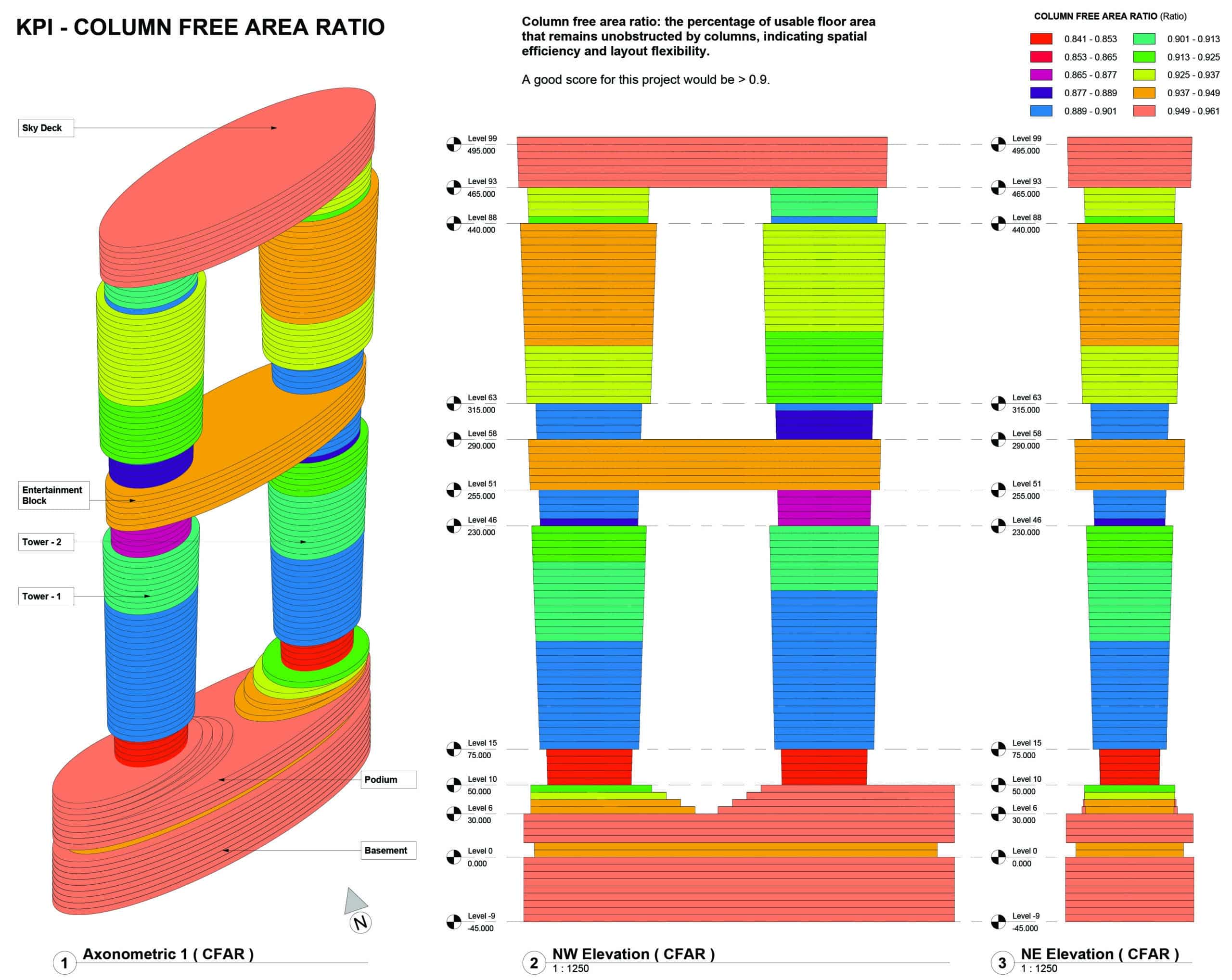

CFAR documentation sheet showing schedule-based validation by level.

2. Material Usage Intensity (MUI)

MUI documentation sheet with filtered volumetric views and schedule by level.

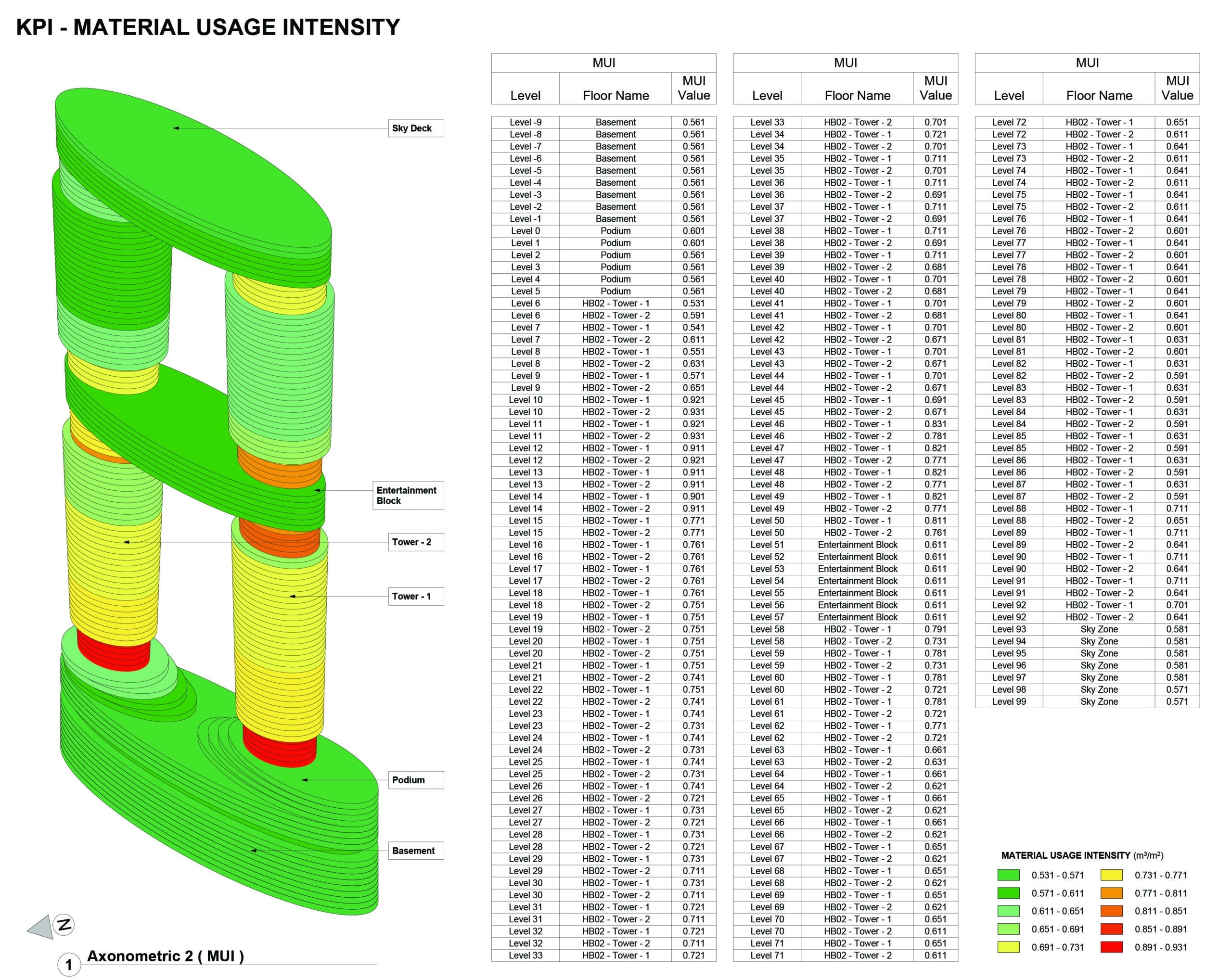

MUI documentation sheet showing schedule-based level comparison.

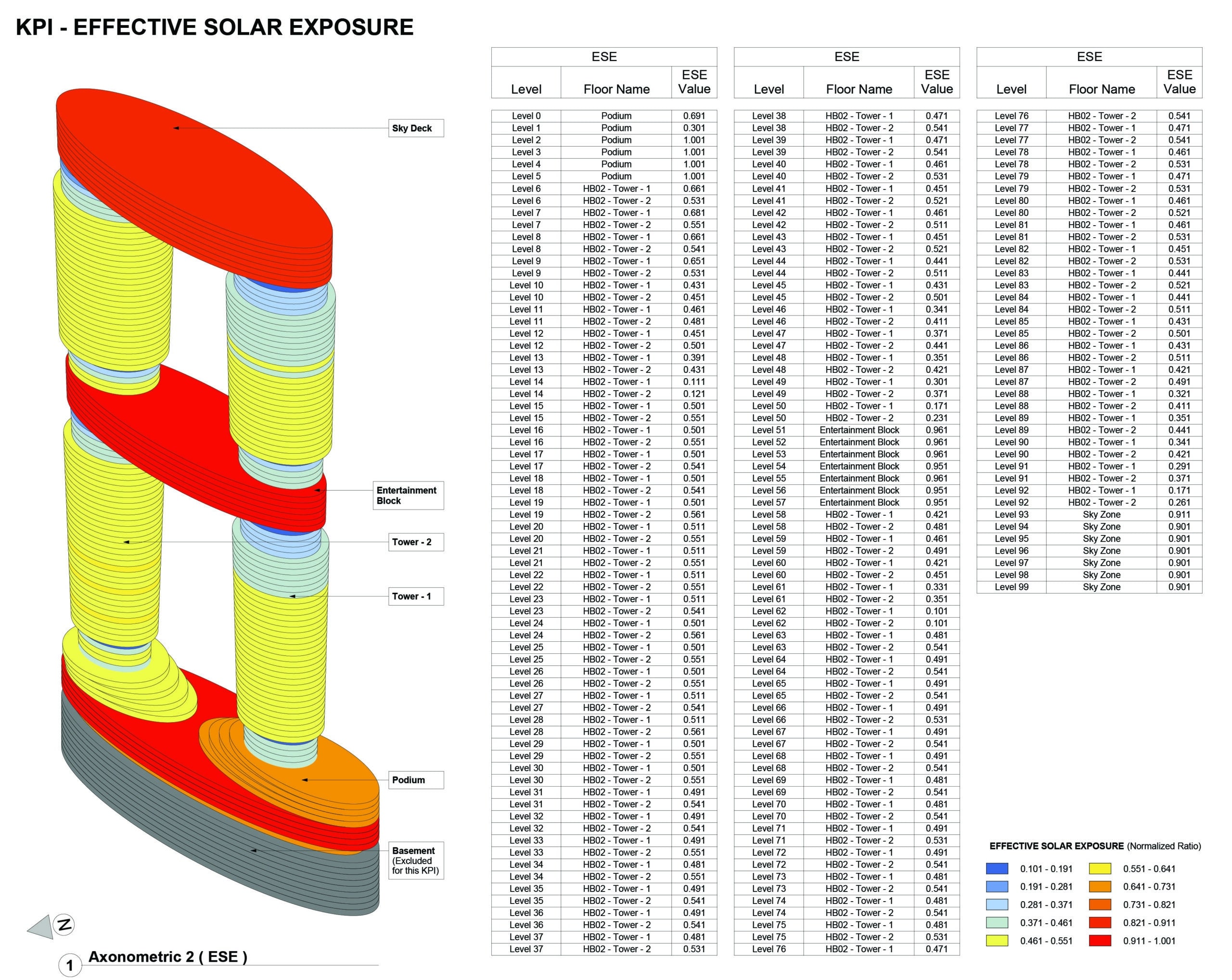

3. Effective Solar Exposure (ESE)

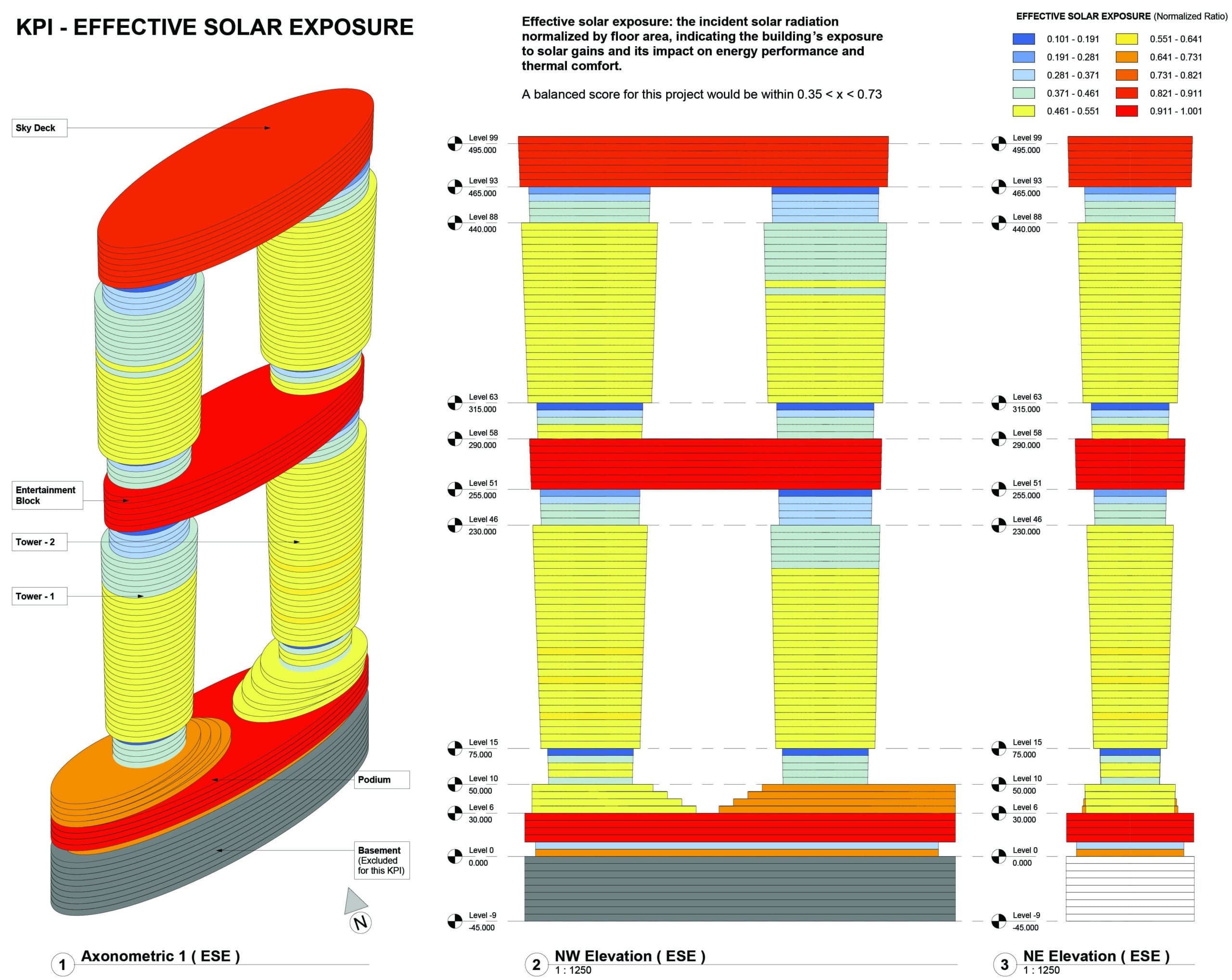

ESE documentation sheet showing normalized solar exposure across the building.
ESE documentation sheet with schedule-based validation by level.

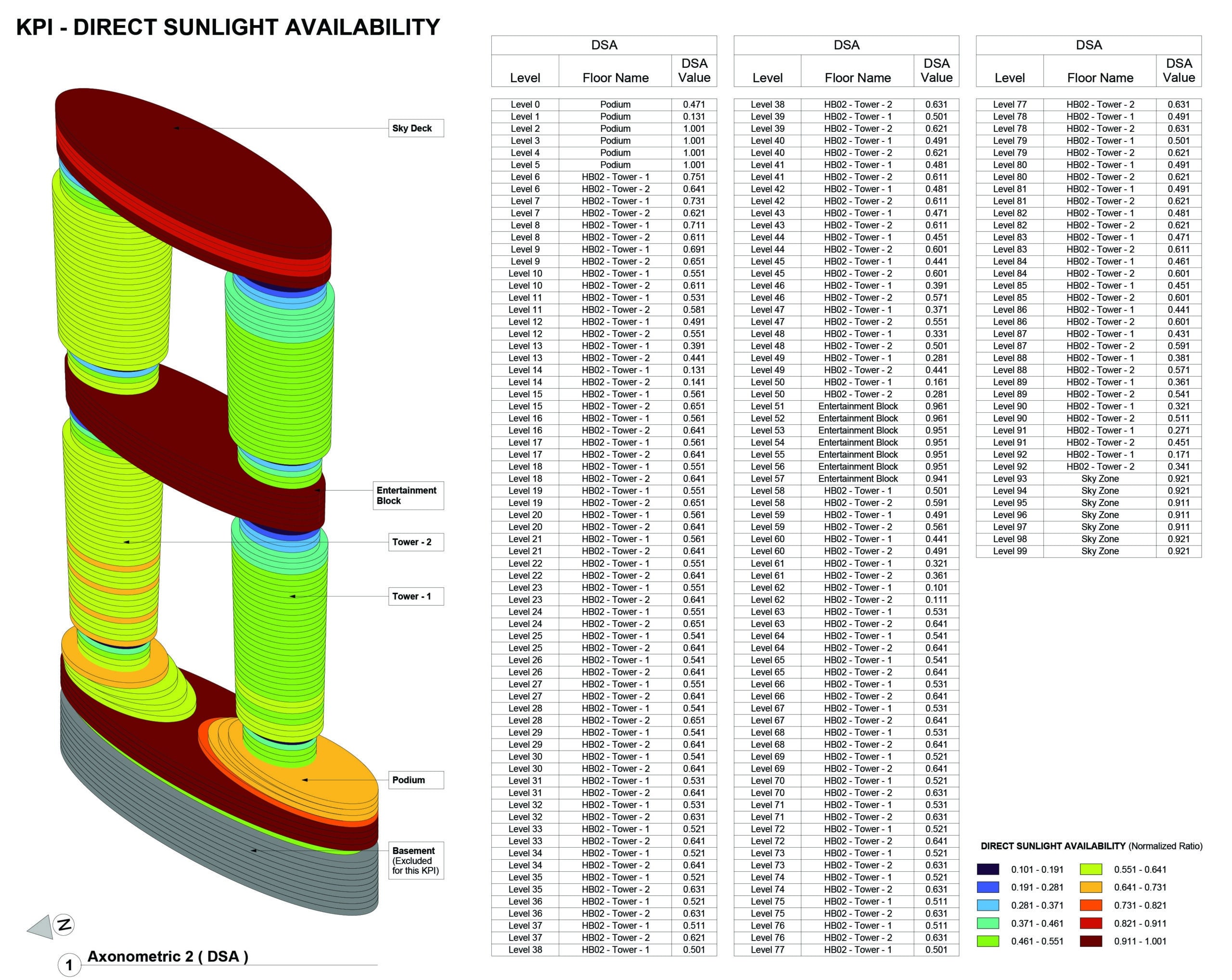

4. Direct Sunlight Availability (DSA)

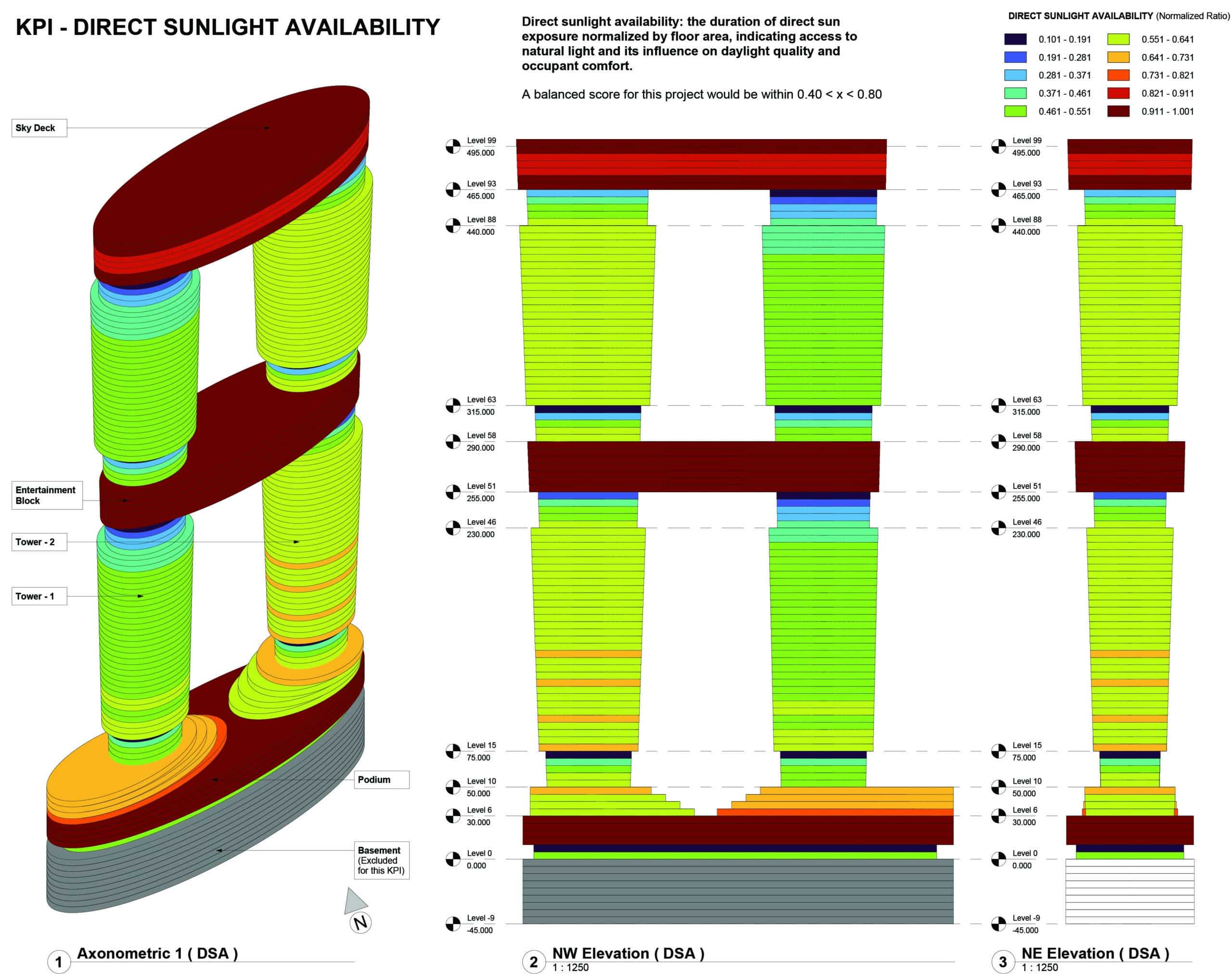

DSA documentation sheet showing daylight availability by level and schedule.
DSA documentation sheet with level-based schedule validation.

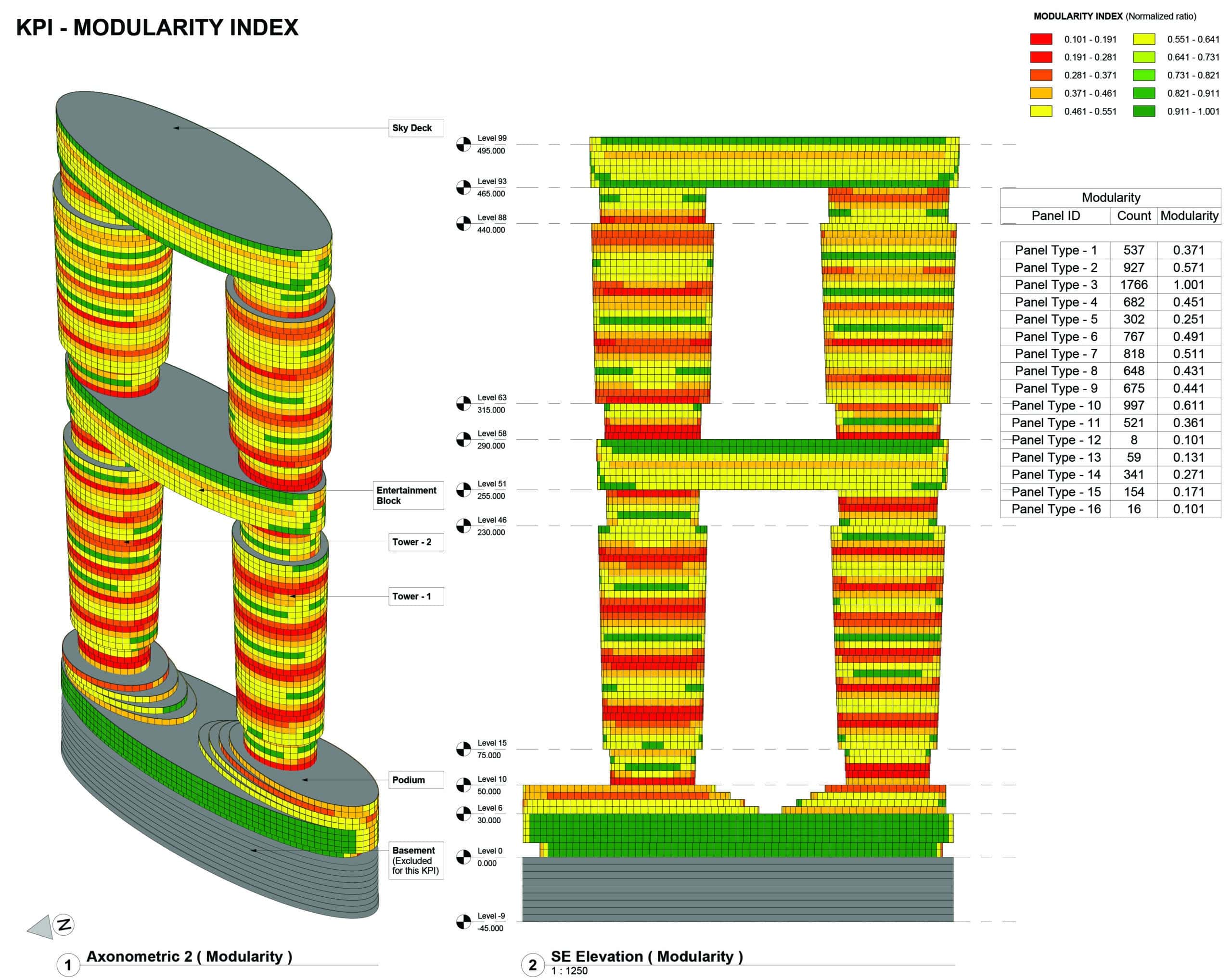

5. Modularity Index (MI)

Modularity documentation sheet showing façade panel repetition and type distribution.

Modularity documentation sheet with schedule and panel type counts.

Analysis: Incident Solar Radiation (ISR)

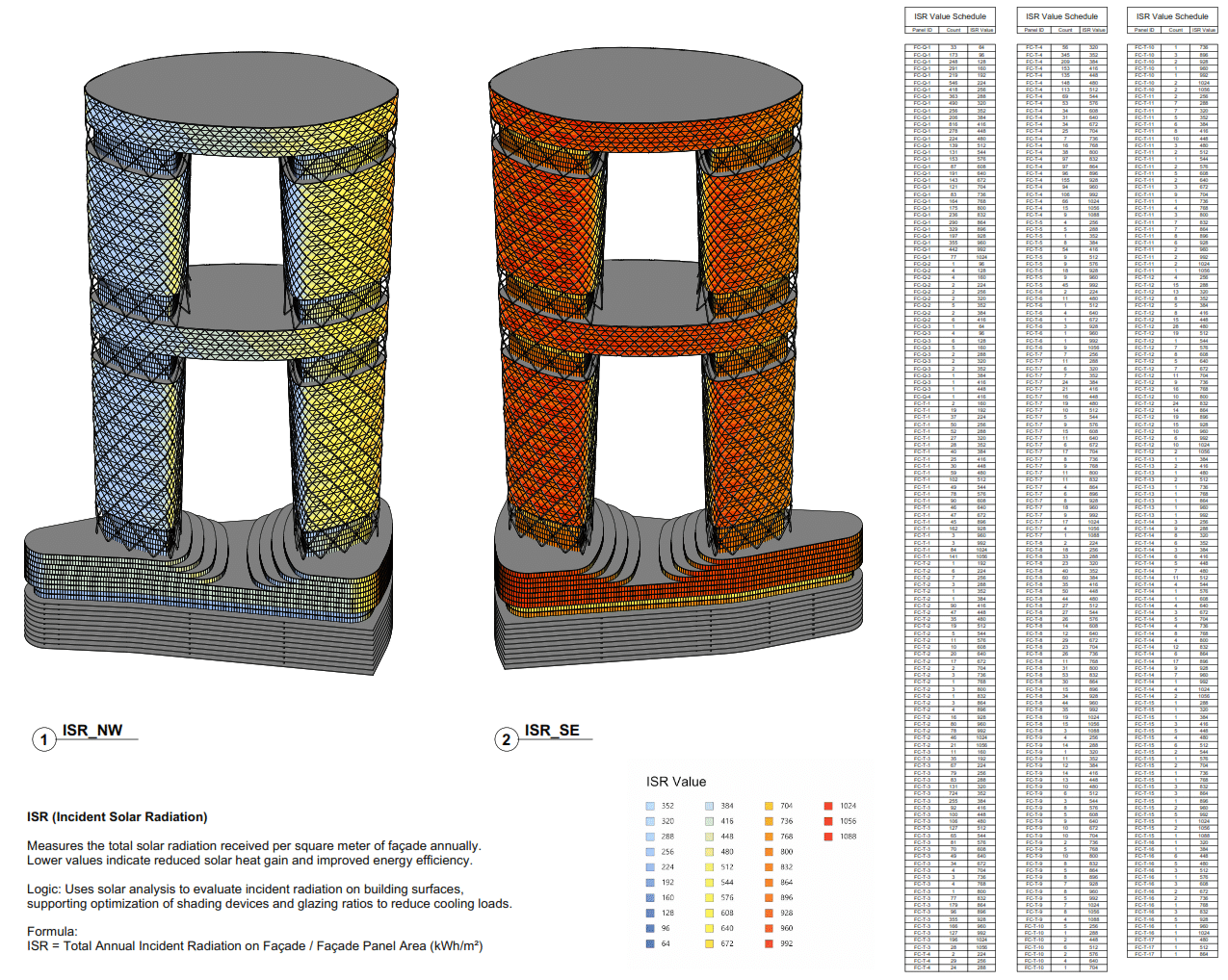

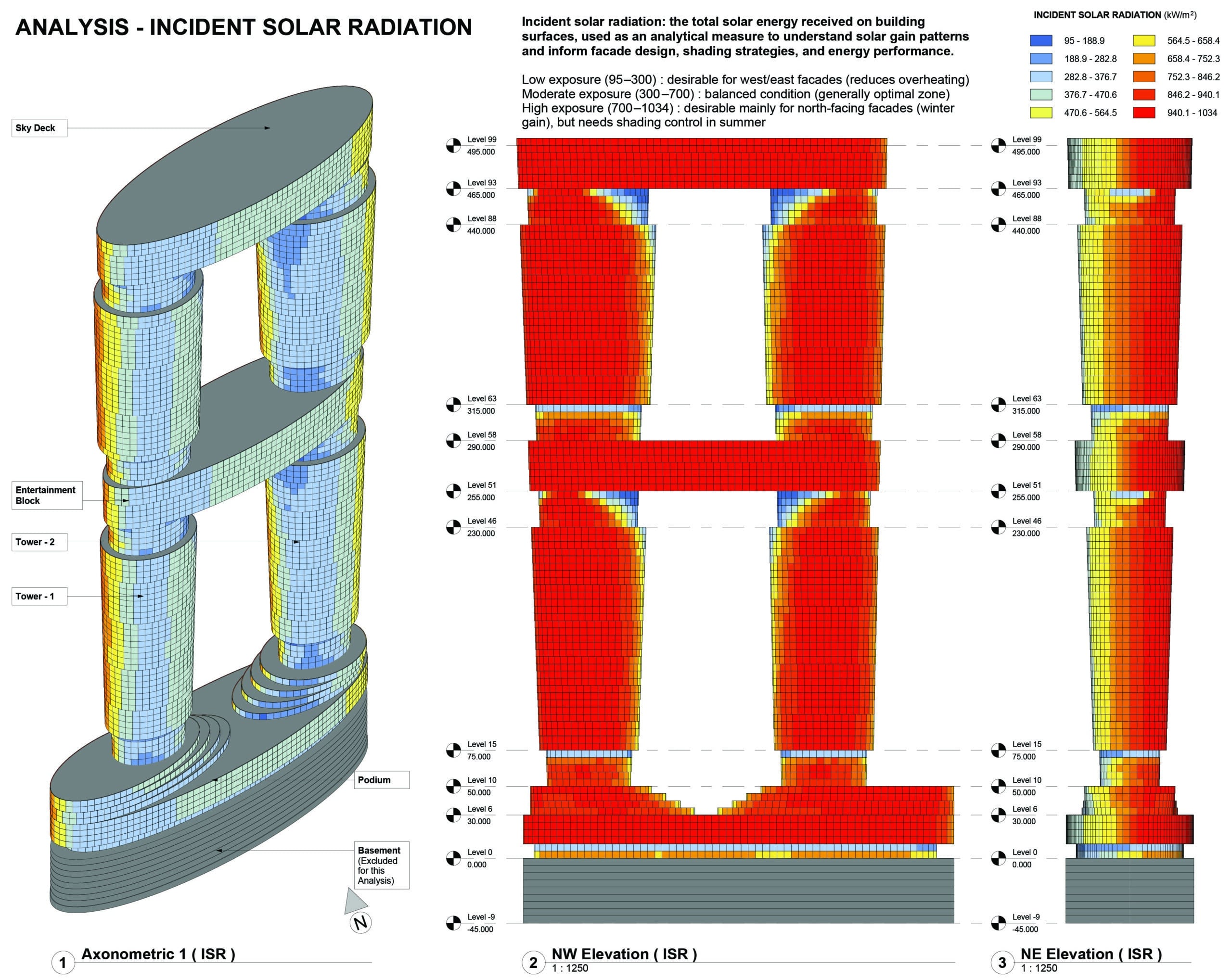

ISR analysis sheet showing façade radiation ranges and analytical views.

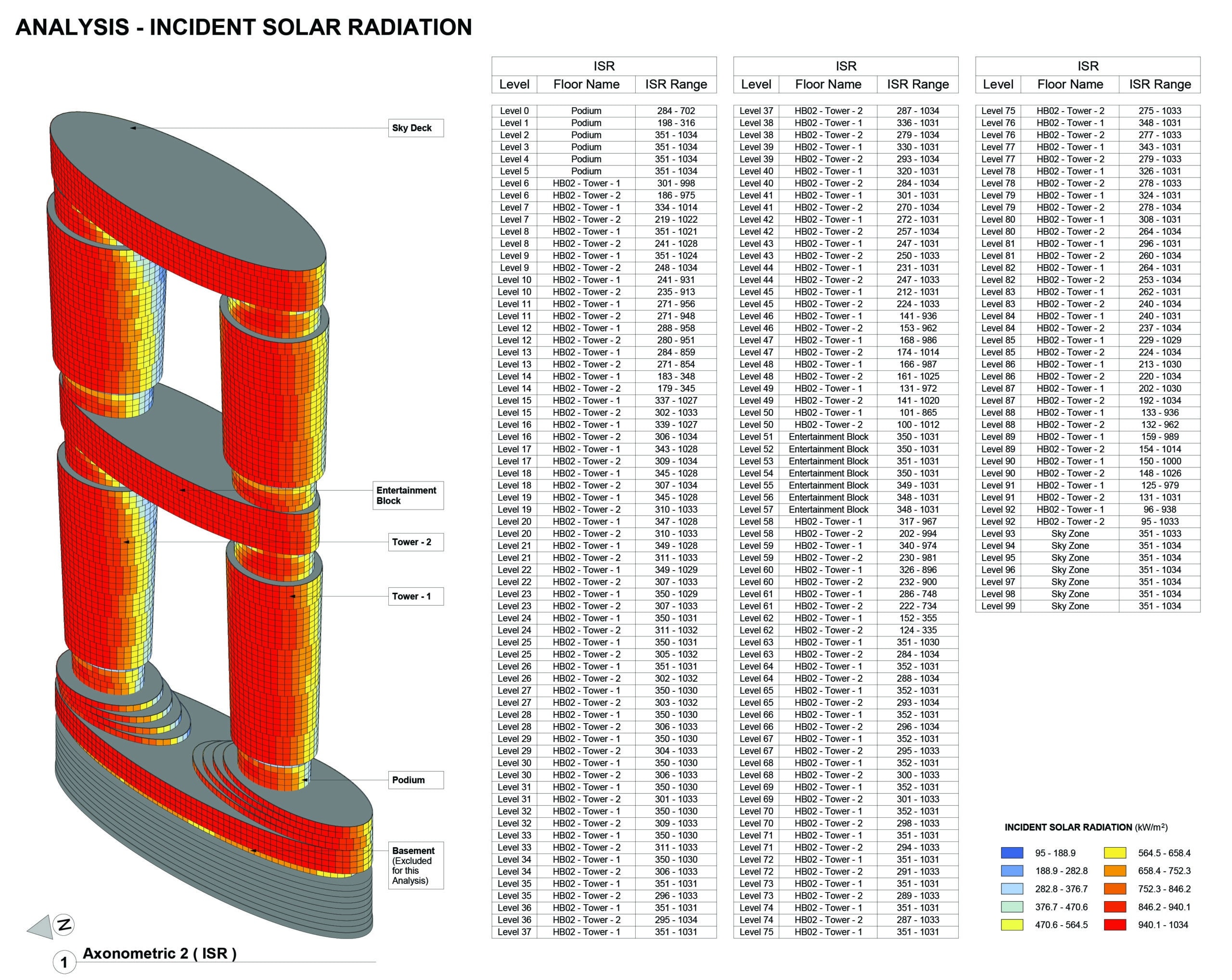

ISR analysis sheet with schedule-based façade radiation ranges.

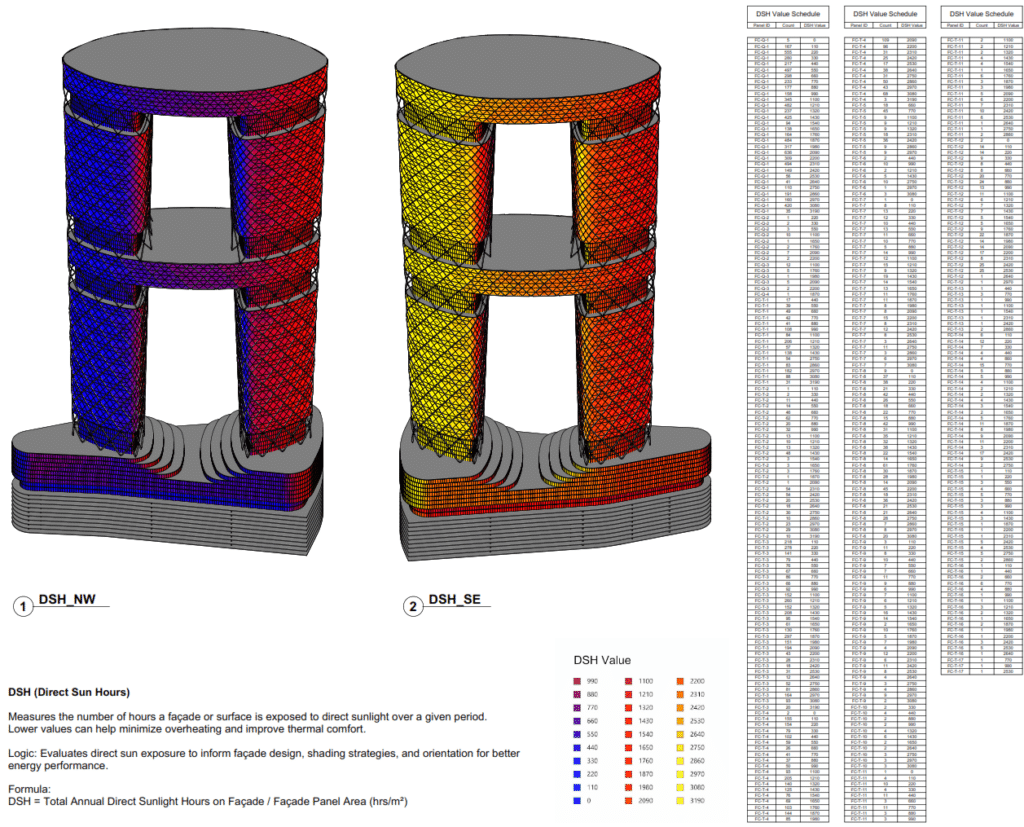

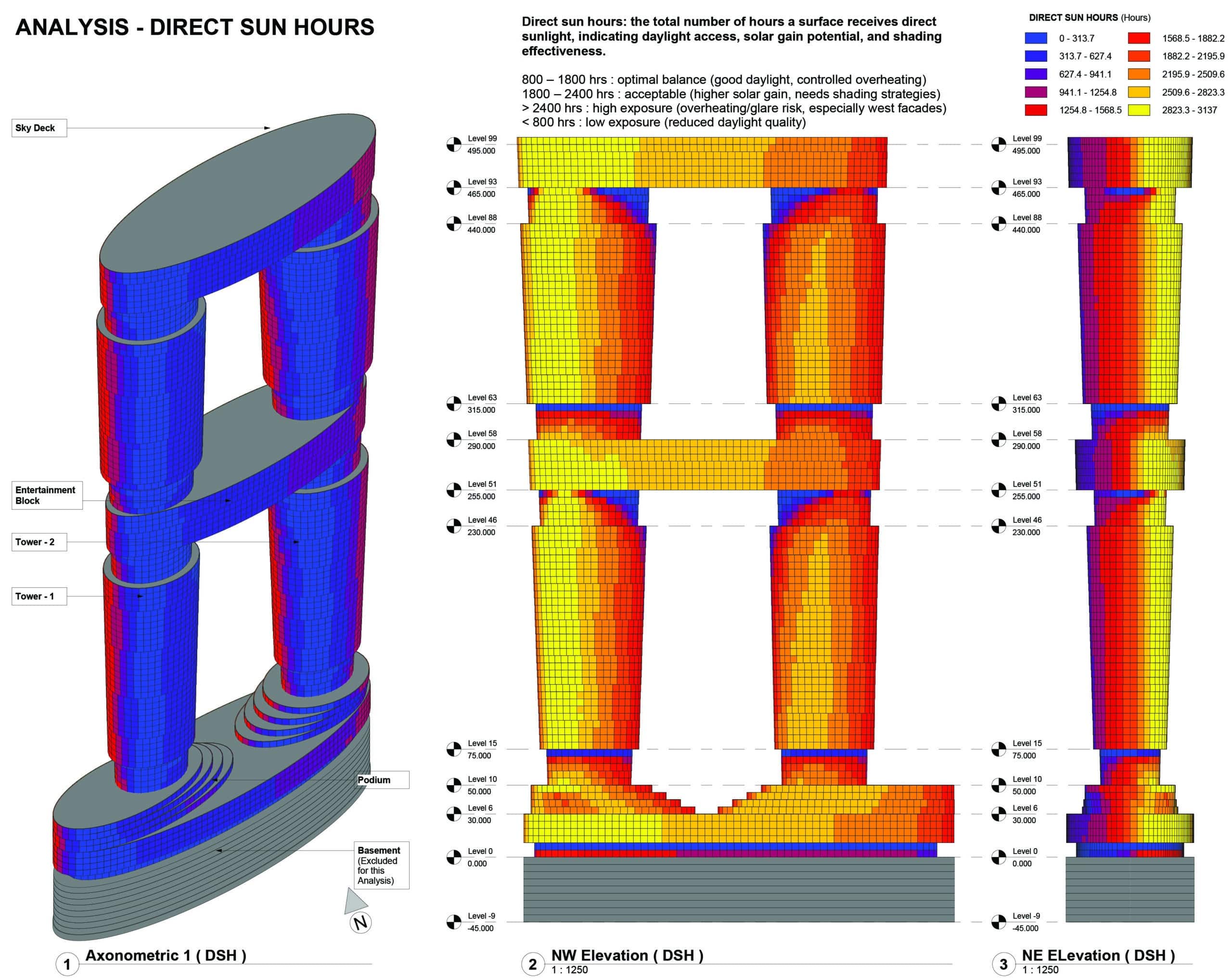

Analysis: Direct Sun Hours (DSH)

DSH analysis sheet showing façade sun-hour ranges and analytical views.

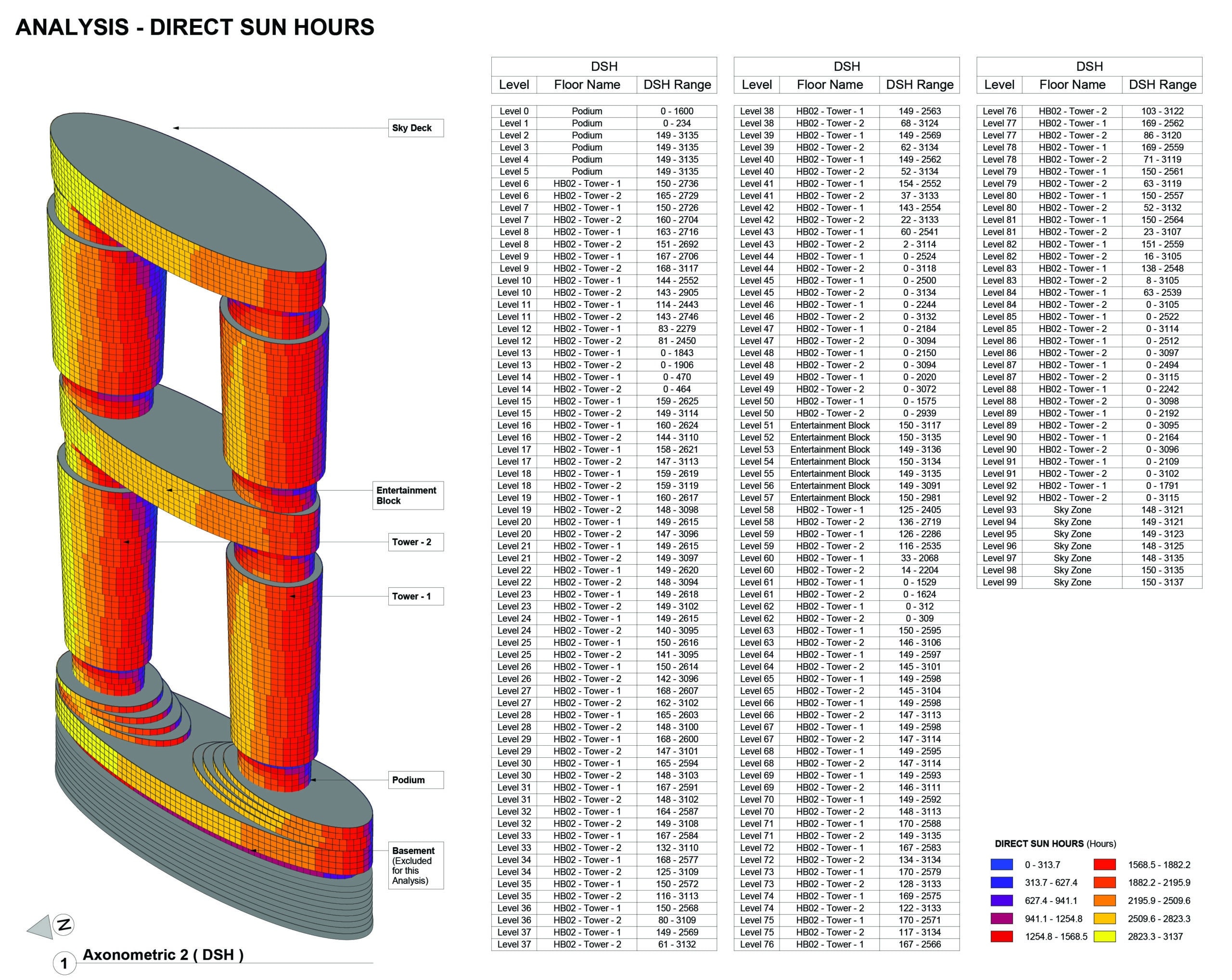

DSH analysis sheet with schedule-based direct sun hours ranges.

From Data to Native Revit Documentation

The final output of the workflow is not a dashboard detached from the model. It is a coordinated documentation set where KPI values appear in schedules, diagrams, elevations, exploded views, and color-coded sheets. This gives designers and reviewers access to numerical information, visual interpretation, and architectural representation within the same Revit environment.

Revit sheets showing KPI schedules, diagrams, and model-based documentation outputs.
The final output is a coordinated documentation set where KPI values appear directly in sheets, diagrams, schedules, and model views.

System Identification and Typology Logic

The workflow begins with a level-based volumetric abstraction used to compare KPI behavior across the building mass. Once the metrics are stabilized and validated through schedules, the process shifts toward a detailed model layer where naming systems, typology control, modularity, and constructibility can be documented natively in Revit.

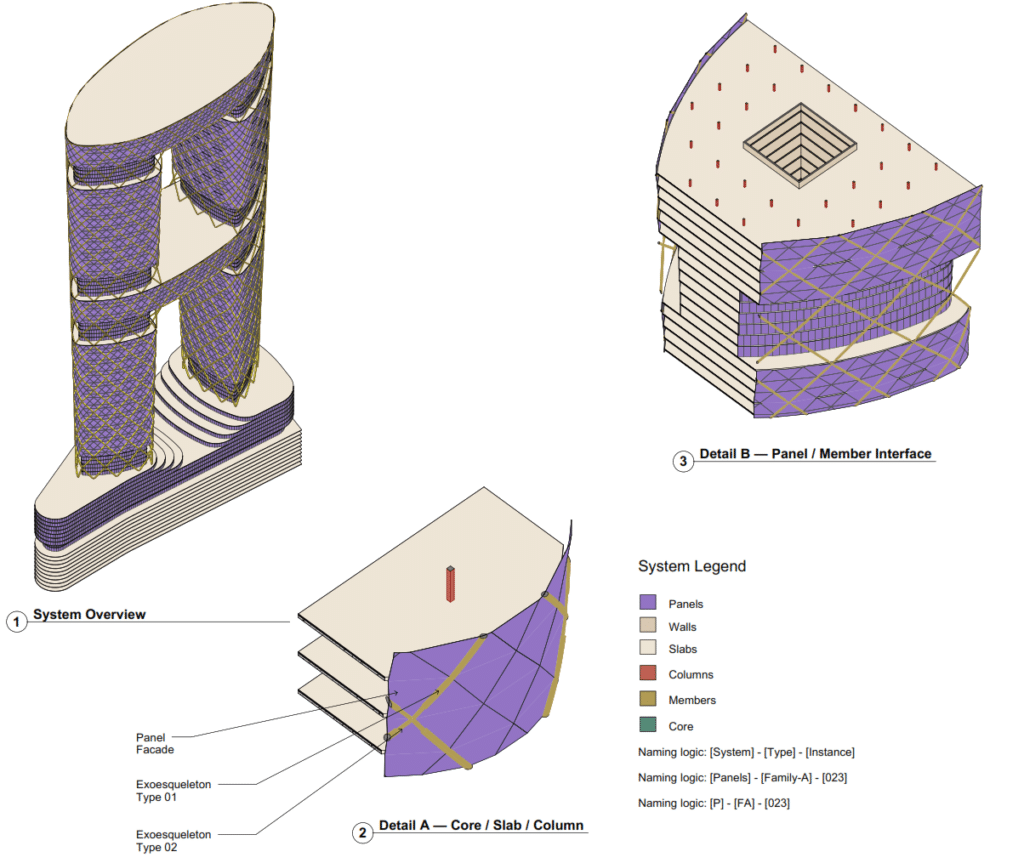

System overview showing panel, slab, core, column, and exoskeleton relationships.
System overview showing panel, slab, core, column, and exoskeleton relationships.

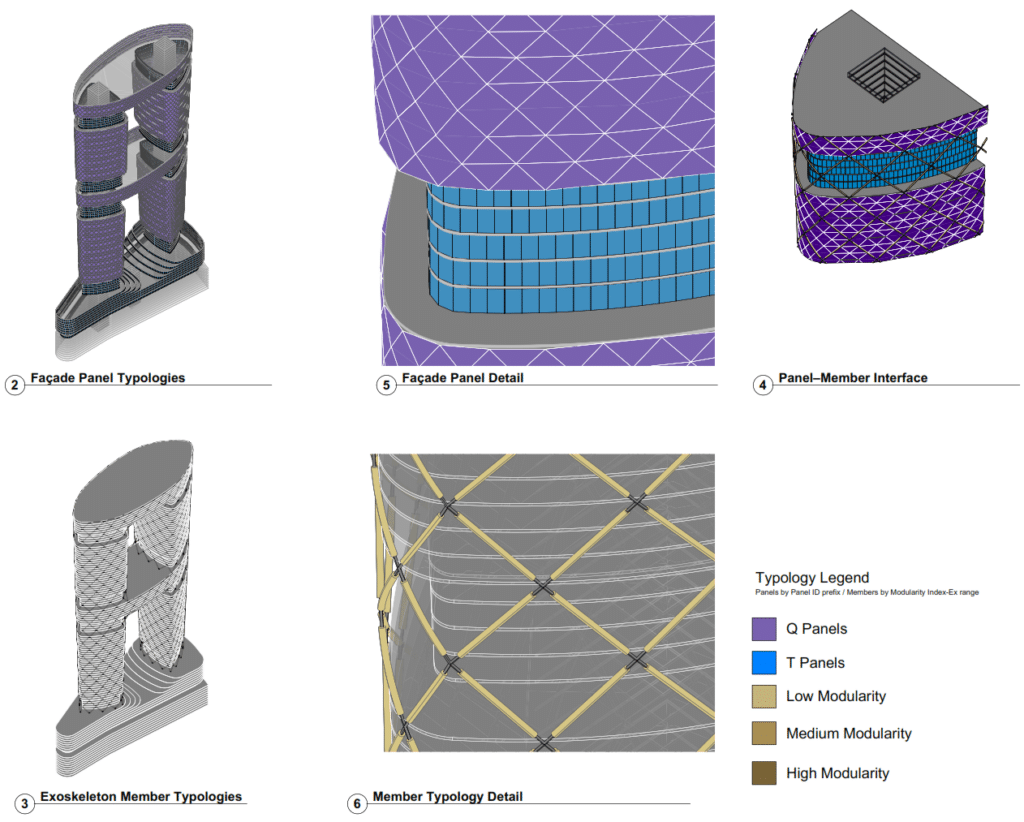

Typology views grouping panels by Panel ID prefix and members by modularity range.
Typology views grouping panels by Panel ID prefix and members by modularity range.

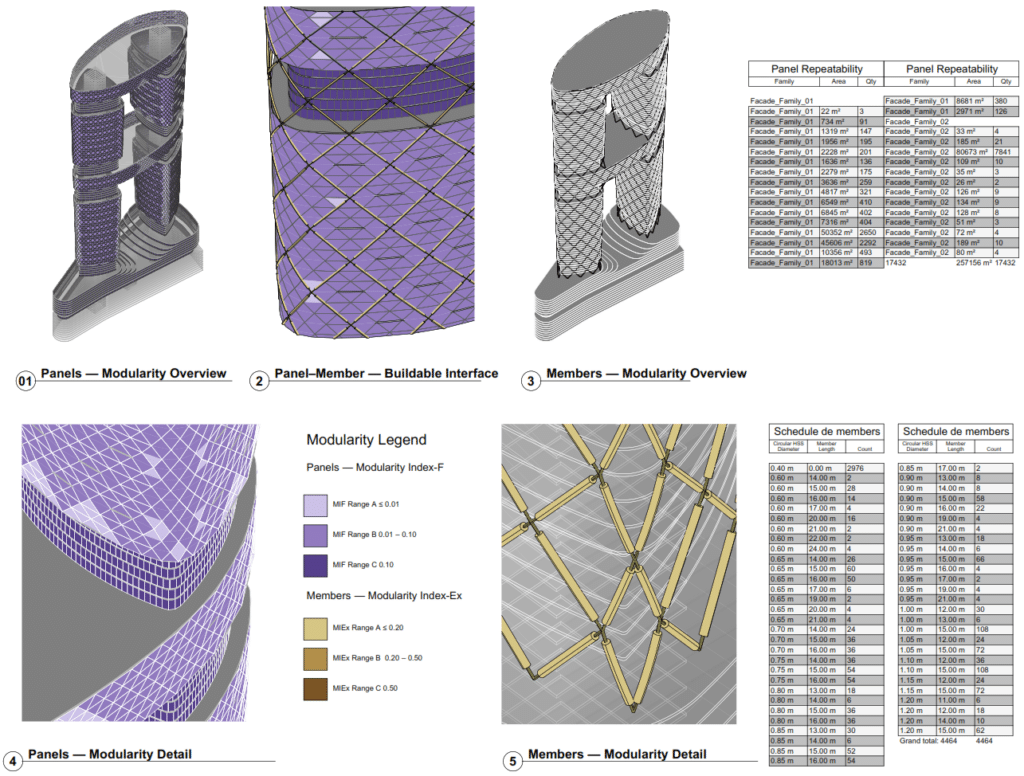

Modularity and Constructability Control

Modularity and constructability sheet showing panel repetition, member ranges, and buildable interfaces.
Modularity and constructability sheet showing panel repetition, member ranges, and buildable interfaces.

Workflow Success Criteria

Integration. Performance metrics become part of the BIM model.
Readability. The same data drives both visual interpretation and formal documentation.
Reliability. Structured parameter mapping improves consistency across outputs.

Current Limitations and Improvement Areas

The workflow still depends on robust parameter naming, consistent element association, and stable mapping between Grasshopper and Revit. Any mismatch in those structures can affect KPI assignment and documentation accuracy. In addition, current color visualization relies on predefined value ranges, which limits dynamic threshold control directly inside Revit.

Conclusion

Hyperbuilding 02 Data Team did not simply calculate metrics. It built a framework where KPI evaluation becomes interoperable, visual, and documentable. In that sense, the project demonstrates a key ambition of integrative modeling: not only to move geometry between platforms, but to move intelligence, criteria, and decision-making into the BIM model itself.
